restored home, for sale, architecture, home, house, sale, restoration, renovation, building, repair, design, business, roof, window, realty, construction, sign, restore, property, color, white, improvement, project, for sale, for sale, restoration, renovation, renovation, renovation, renovation, renovation, realty. Preservation Contractors Timeline: When to Call
Photo by paulbr75 on Pixabay

Features

Part of Preservation contractors: nineteen trades and how to find them

Preservation Contractors Timeline: When to Call

A preservation contractors timeline for seasonal trades, matching materials, weather delays, review queues, and written schedules for old-house work.

What to take away

  • Book specialist trades in the previous season, not in the season you want the work done.
  • Matching materials, not labor, is usually the longest single lead time on a preservation job.
  • Weather-dependent trades reschedule constantly. Flexibility buys you an earlier slot.
  • Anything requiring a review or an application adds a queue you do not control.

For a preservation contractors timeline, start by calling before the season you want the work done. Preservation trades are thin on the ground and their calendars fill early. Asking sooner gives you more room to plan.

When to make the call

WorkWhen to be asking
Exterior masonry and repointingPrevious autumn or winter
Exterior paintingPrevious winter
Roofing in slate or tileSix months out, longer after a storm season

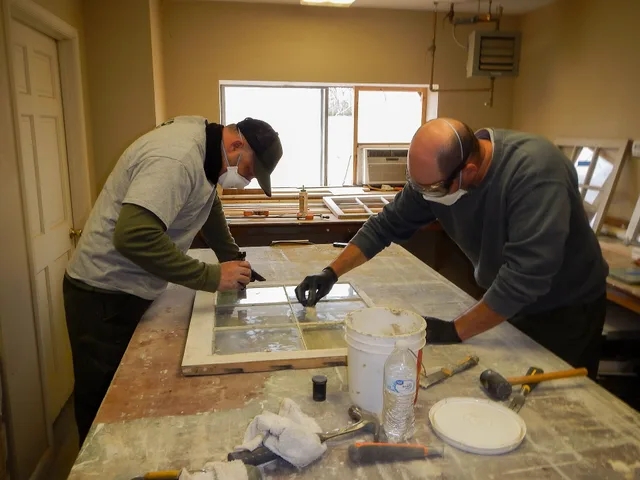

Sash restoration in a shopAny time, but book winter slots in summer
Ornamental plasterSix months out, longer for run work
Structural repairAs soon as the engineer's report exists

Storms distort all of this. After a regional weather event, every roofer and mason within a hundred miles is booked, and the good ones are booked first.

When to Book Preservation Trades

  1. Previous autumn or winter
    Exterior masonry and repointing
  2. Previous winter
    Exterior painting
  3. Six months out
    Roofing in slate or tile
  4. Any time, winter slots in summer
    Sash restoration in a shop
  5. Six months out
    Ornamental plaster
  6. As soon as report exists
    Structural repair

The practical response is to keep a relationship rather than a phone number. A firm that has done one small job for you already will fit you in ahead of a stranger, which is another argument for starting with something small.

Materials set the real date

Matching an existing building means ordering made items rather than stocked ones. Quarried stone to match an existing wall is the clearest example.

The General Services Administration’s (GSA) Installation of New Limestone to Match Existing procedure for installing new limestone explains how to match color, bedding, texture, and finish. Each step is a decision to make before placing an order.

The same goes for slate from one quarry, nonstandard brick, turned porch parts, run plaster profiles, and reproduction hardware. Run plaster deserves the most thought: replicating a cornice earns its cost in one principal room and rarely in all of them.

Ask for a written lead time with every quote, then build the schedule backward from the longest one.

Queues you do not control

Projects seeking federal historic tax incentives add a review queue. The National Park Service (NPS) administers the Federal Historic Preservation Tax Incentives program; applicants use the Historic Preservation Certification Application, and proposed work is evaluated under the Secretary of the Interior’s Standards for Rehabilitation. Applicants can use the NPS searchable database to check the status of an application; contact your State Historic Preservation Office (SHPO) to ask about the current review queue before setting a start date.

The practical lesson generalizes. Find out how long the queue is, what starts the clock, and what stops it.

Holding a slot without regret

  • Ask what deposit holds a date and what it is refundable against.
  • Agree what happens if weather moves the start, and who bears the cost.
  • Confirm whether your job can be paused if the firm gets an emergency call.
  • Get the sequence in writing so trades do not collide on site.
  • Keep a shorter, flexible job on the list to fill a gap if the main one slips.

A deposit that holds a date is not the same thing as paying ahead of completed work, and confusing the two is one of the hiring regrets that repeats.

The overall project schedule this fits inside is in our timeline for old-house projects, and the map of which trade you are booking is in the nineteen preservation specialties.

Common questions

How long is too long to wait for the right firm?
If the building is stable, a season is worth waiting. If water is entering, stabilize now and do the good work later.
Will paying more get an earlier date?
Rarely with reputable specialists. Flexibility and a well-prepared job get you further.
Should I book several trades at once?
Book them in dependency order, with realistic gaps. Overlapping trades in an occupied house causes more delay than it saves.
What if a contractor goes quiet?
Follow up once in writing, then move on. A firm that cannot answer an email will not answer one from a job site either.
